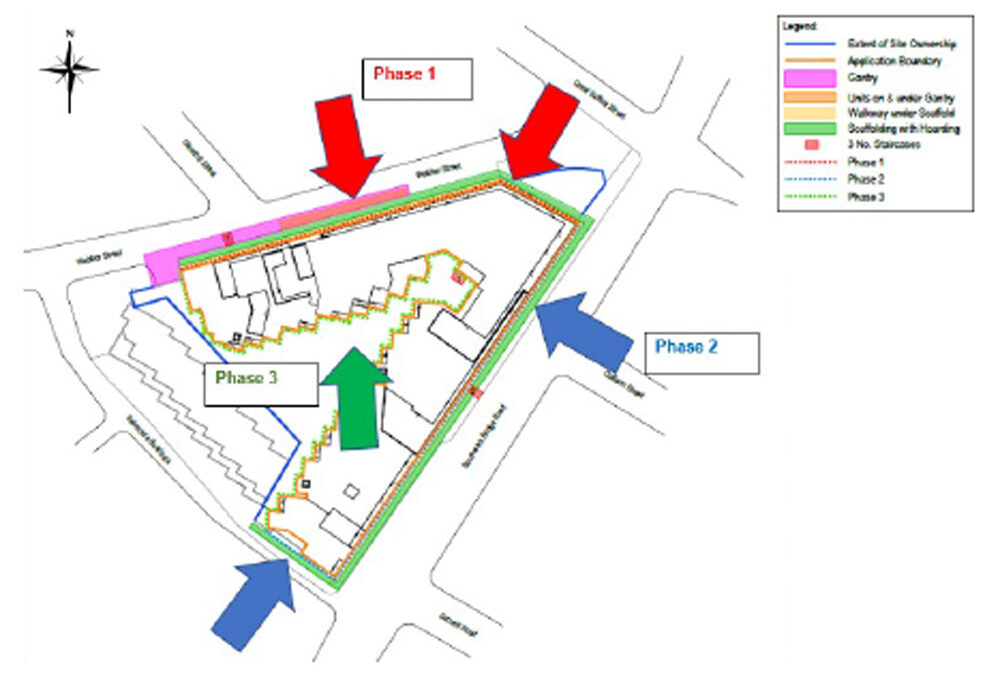

Phase 3 – Work Phasing Plan

Phase 3 – Work Phasing Plan

Work Phasing Plan Each Phase of Works is proposed to have a sectional completion. Phase 3 Courtyard 8th August 2022 – 23rd August 2023 54 weeks The reason for this sectional approach to is to strike scaffolding to each section as quickly as possible in order to...
Phase 3 – Work Phasing Plan

Phase 2 – Work Phasing Plan

Work Phasing Plan Each Phase of Works is proposed to have a sectional completion. Phase 2 Southwark Bridge Road 21st June 2022 – 5th May 2023 45 weeks Belverdere Buildings 25th July 2022 – 3rd February 2023 27 weeks
Phase 3 – Work Phasing Plan

Phase 1 – Work Phasing Plan

Work Phasing Plan Each Phase of Works is proposed to have a sectional completion. Phase 1 Webber Street 7th February 2022 – 11th January 2023 48 weeks Great Suffolk Street 27th April 2022 – 3rd March 2023 44 weeks

Fire notice to All Residents

Dear Resident As you may be aware the cladding system at the building will be replaced and a new fire alarm system installed. In the interim it is important for all residents to read the information below. Fire Safety Awareness Smoking should not take place in the...

Locking of Balcony Doors

Balcony Doors We have undertaken a risk assessment in which we have consulted with the client’s health and safety advisor to assess the most appropriate way to ensure safety for all residents during the construction works (cladding remediation and balcony replacement...
